Beta

This is a new service and pages are being tested and improved.

Earlier this year, HM Land Registry (HMLR) was in the process of setting up a Centre of Project Delivery Excellence (CoPDE). Our aim was to establish consistent ways of working across all programmes and portfolios which would support our project delivery practice and improve our data and reporting capability.

At the same time, we heard that the National Infrastructure and Service Transformation Authority (NISTA) wanted volunteers to participate in a pilot of their forthcoming ‘Programme and project data standard‘ (the standard). This was ideal timing, as we were able to use our participation in the standard pilot to support the development of apps and automated reporting.

The assessment process and staff engagement

Our CoPDE team completed a review of the quality of our existing project data, how it was captured and managed, and where it was stored. Based on our findings, we discovered there were multiple areas that were already aligned to the proposed standard. Therefore, adopting the standard was a fantastic opportunity to standardise our data.

We introduced the pilot to our project delivery practice during one of our scheduled ways of working sessions. We also briefed our programme support officers, risks and benefits teams, to make them aware of the standard and explain our plans for adopting it.

How the standard was used

Our vision is to provide as much automated reporting as possible. The standard has helped ensure we are being consistent across different areas of project delivery.

The standard has influenced the data structure for our dependency data collection app (Figure 1), milestone SharePoint list (Figure 2), and project/programme information collection (Figure 3).

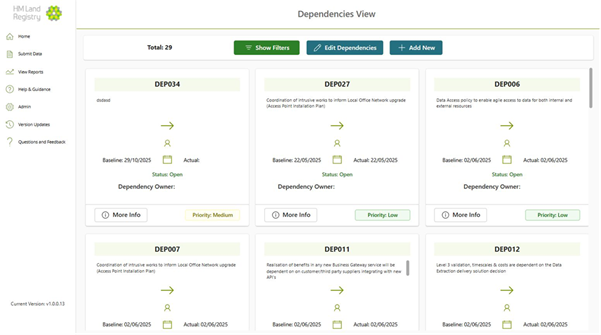

A dashboard titled “Dependencies View” from HM Land Registry. It displays six dependency cards in a grid layout, each with a code and details:Examples include DEP034, DEP027, DEP006, DEP007, DEP011, DEP012. Each card shows baseline and actual dates, status (Open), and priority labels (Medium or Low). Buttons for “More Info” and priority tags are visible. The top bar includes buttons for Show Filters, Edit Dependencies, and Add New. The left sidebar menu includes Home, Submit Data, View Reports, Help & Guidance, API, Version Updates, and Questions and Feedback.
Figure 1: Dependency data collection app
A project management interface titled “Centre of Project Delivery Excellence.” The page shows a table labeled “TDD-Milestones” with columns: Programme Code, Programme Name, Milestone Title, Milestone Created Date, Milestone Planned Date (Baseline), Milestone Forecast Date, Milestone Actual Date, and Milestone Category.One row is visible with Programme Code VST2025 and Milestone Title “Test Milestone.” Most columns display “No project info.” The top bar includes options like Add New Item, Edit Grid View, Share, Export, and Automate. The left sidebar lists navigation options such as Home, Conversations, Documents, Notebooks, Pages, and TDD Milestones.
Figure 2: Milestone SharePoint list

A project management dashboard titled “Another Test Plan.” The screen shows multiple sections:General: Project ID (P999), Project Name (Another Test Plan), Project Type (Security), Priority (Moderate), Stage (Create), Overall Status (Amber). Schedule: Estimated Start Date (19/11/2025), Duration (80 days), Finish Date (10/02/2026), % Complete (0.1%). Effort: Effort (8 hours), Effort Completed (4 hours), Effort Remaining (4 hours). Navigation tabs at the top include Summary, Schedule, Documents, Status, Interdependencies, Financials, Business Planning, and Baselines. The left sidebar lists menu options like Plans, Programmes, Status Reporting, Reporting, Interdependencies, and Admin.
Figure 3: Project/programme information collection

The benefits of applying the standard

Introducing the concept of the standard has involved a change in mindset, increasing awareness of the value and power of good quality data across the organisation and wider government. It has meant looking outward and not just within the programme delivery structure. The theory has been an easy sell, but it has been much more challenging to practically apply the standard, particularly in well-established programmes, for example, one person’s deliverable is another person’s milestone.

From a technical perspective, the standard has and will continue to help with the communication of our needs related to building new tools and designing data structures. When discussing with developers and system owners, we can point to the standard rather than personal preferences.

We know that introducing the same process makes data collection easier and helps us identify when things change from our baselines. Using the standard makes it easier to talk about our project delivery data needs with our stakeholders.

Lessons learned

It is easier to start using the standard in newly formed projects and programmes.

Using the standard as a reference reduces any potential confusion when requesting changes to systems or templates, since we can point to agreed definitions rather than “our interpretation.”

Build in governance and monitoring. Without checks fields can drift away from the standard over time. Technical validation rules and automated checks can help embed consistency.

Identify your stakeholders and involve colleagues from other departments to help with implementation and monitoring benefits. Plan stakeholder communications and provide opportunities for feedback and discussion before, during and after implementation. There can never be enough awareness of this.

Use the support and advice that is offered by NISTA, particularly the resources that they provide, they are very helpful when presenting to stakeholders.

Advice for others and next steps

Just do it! Don’t wait to build agreement. As a profession we can take responsibility for implementing the standard and we should feel empowered to do it.

Consistency is key. Make sure you build in monitoring the application of the standard and support the process of embedding it – you need to invest in it until it becomes second nature.

Get ahead of the curve, with so much emphasis on data across government the standard is becoming mandatory.

Author

Lesley Jones

HM Land Registry

South West
